This page provides an overview of the key milestones and phases of the Yoctangee Park improvement projects. Residents can follow the progress from the initial planning stages through to the completion of each major development. This timeline will help you understand the expected duration of each project phase. Stay informed about the progress and see how our community is transforming over time.

Phases

Phases overview

Construction

June 1, 2025 - November 1, 2026

The City of Chillicothe is collaborating with Ross County, the state-procured planner American Structurepoint, and the Construction Manager at Risk (CMR), Ruscilli Construction, to carry out the construction activities within Yoctangee Park. This partnership ensures that the construction process is managed efficiently and effectively, bringing the vision for Yoctangee Park to life with the highest standards of quality and safety.

Please note this timeline will be updated as project details progress.


Exterior Roadways Timeline

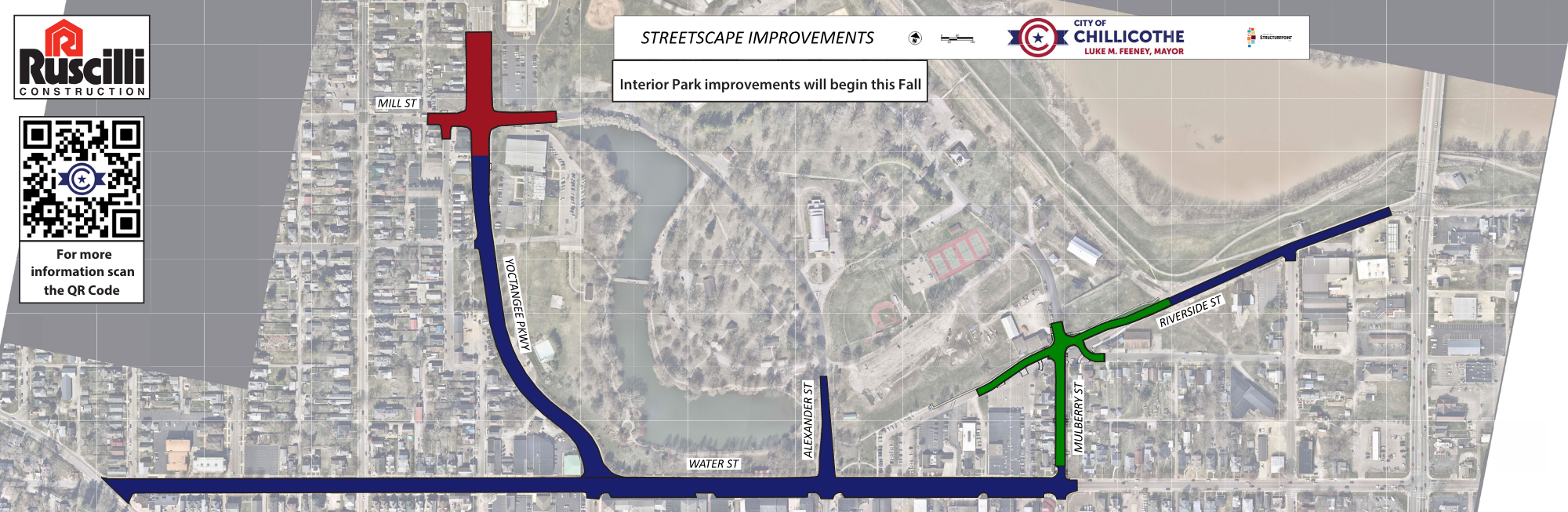

Phase 1: Blue

September 10 - October 3

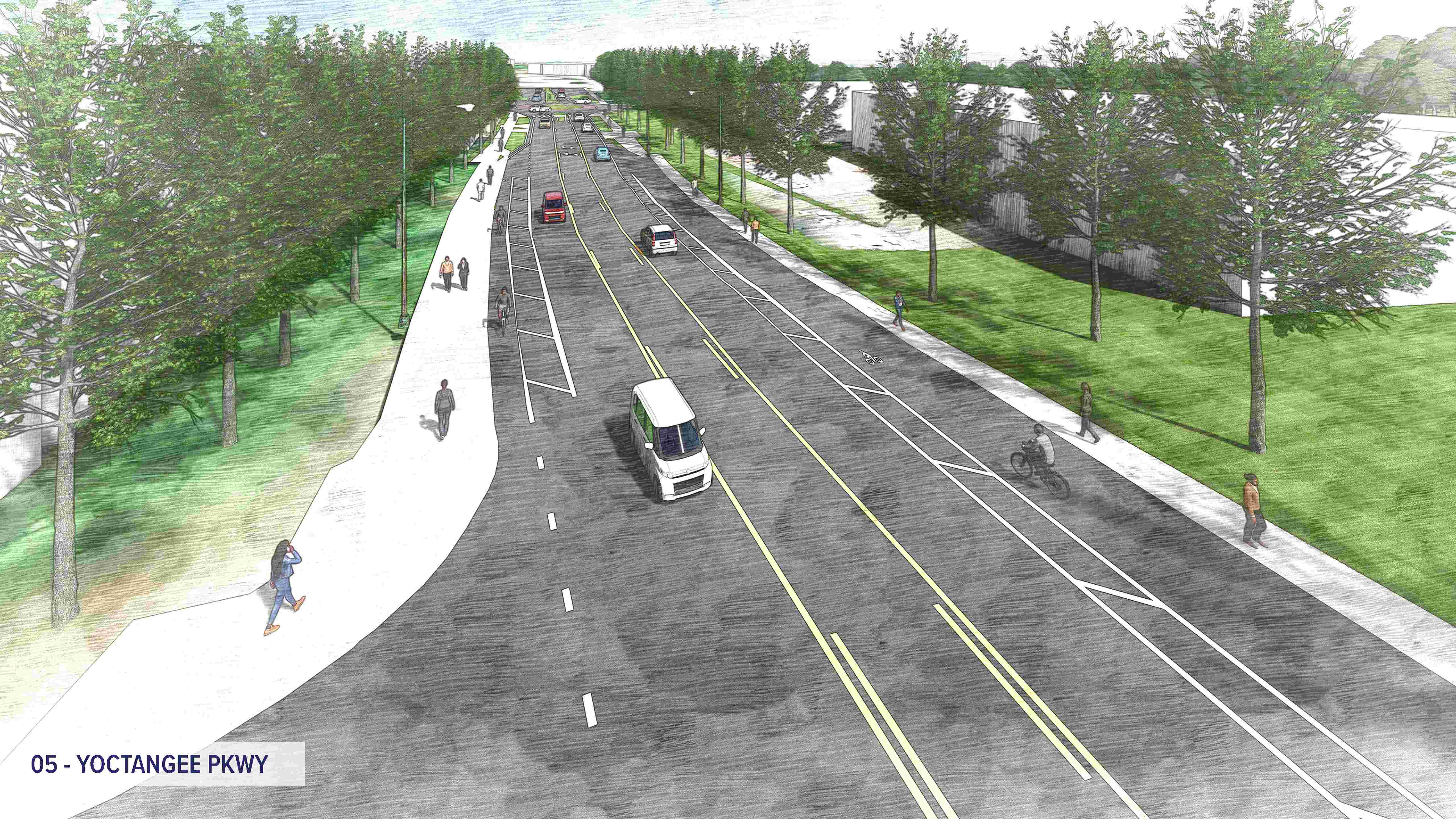

Water St. will undergo pavement resurfacing and striping from Western Ave. to Mulberry St. Lanes between Walnut St. and Mulberry St. will be reconfigured to one lane traffic in both directions with a dedicated center turn lane. Parking along the north side of Water St. will mirror the existing parking on the south side and become angled parking which will allow for additional parking spaces. Yoctangee Pkwy. will receive pavement resurfacing from Water St. to Mill St. Lanes will be reconfigured to one lane in both directions with a dedicated center turn lane as well as a bike lane on the east side. Additionally, a portion of Riverside St. will undergo pavement resurfacing and striping

Phase 2: Green

October 1 - December 12

Mulberry St. will undergo full depth pavement replacement. Intersection improvements will occur at the Mulberry and Riverside St. intersection to realign the Race St. entrance for better traffic control and pedestrian safety


Phase 3: Red

March 2026 - July 2026

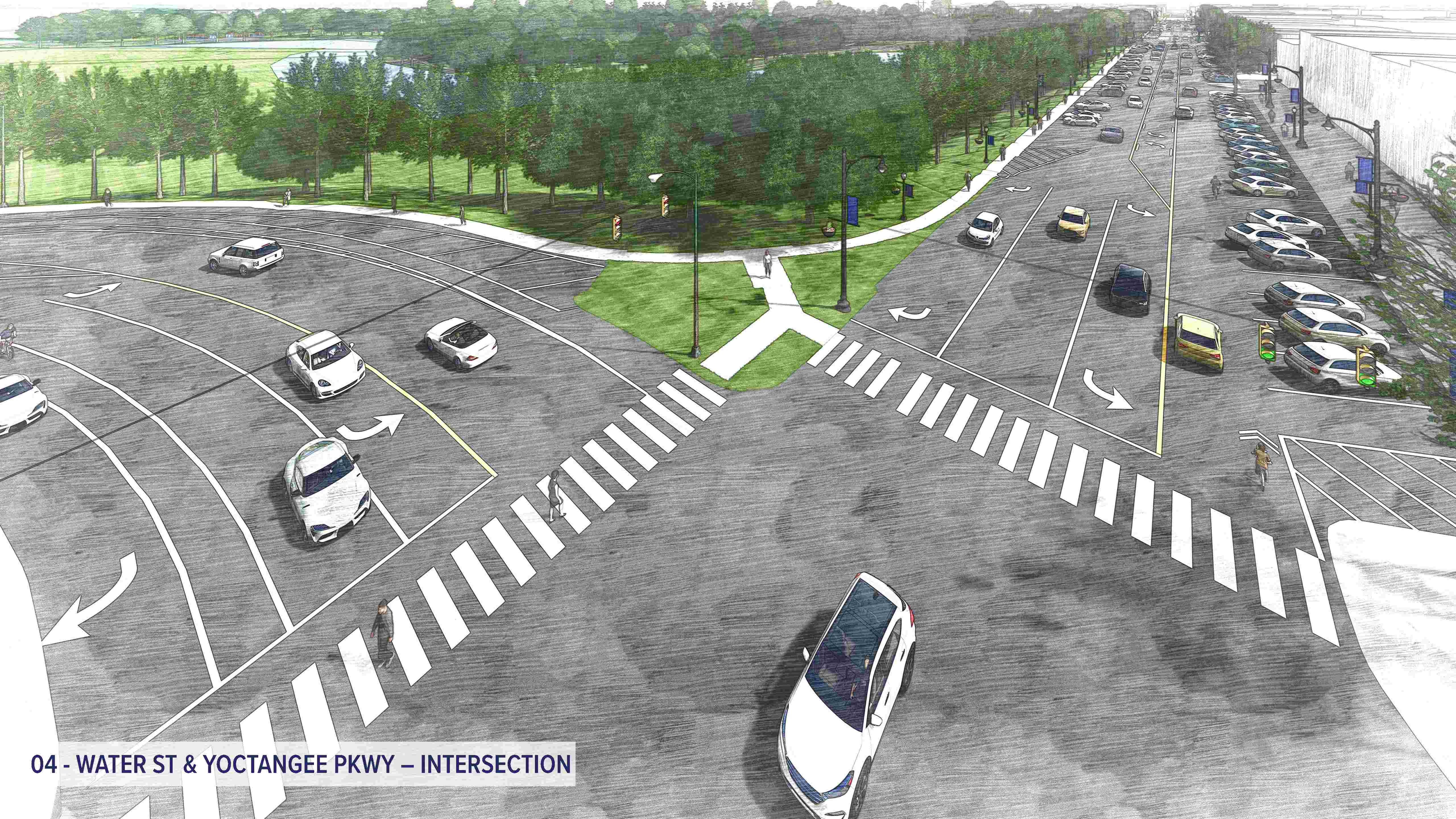

Intersection improvements at Yoctangee Pkwy and Mill St. will include converting the existing traffic light to a single lane roundabout with new lighting and pedestrian safety improvements. Traffic flow will be eased by four splitter islands and crosswalks will be installed at each road crossing.
