Street Paving 2023

Weather permitting, milling will begin at 7:00 AM June 29, Thursday morning on Water Street from the Railroad to Poplar Street, and paving on Friday beginning at 7:00 AM in the same area. Crews will work 7:00 AM - 8:00PM until the scheduled roads are completed. Residents are advised to watch for No Parking signs and to use caution around construction vehicles and crews.

You're viewing real-time data. Participant counts are continuously updated for administrators. Please note that regular users see cached data, which may result in slight differences in the numbers.

Phases

Phases overview
Phase 1: Street Paving Schedule
Street Paving Schedule

Street Paving Schedule

June 29, 2023 - November 1, 2023

Please find a list of streets and parking lots on this year's paving schedule. Crews will begin working Thursday, June 29 at 7:00AM and will work daily until 8:00PM.

Mary Lou Patton Park is slated to be completed by the end of July.

The order of the streets will be determined and we will send out a media notice in advance of those streets being milled and paved. Weather can be a factor sometimes and delay when the work can be done so its difficult to give a set timeframe for the notices, but typically 48 hours in advance.

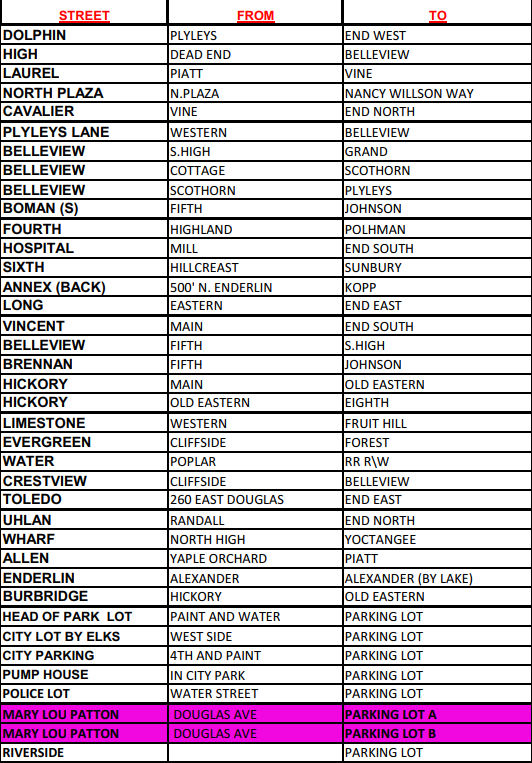

2023 Paving Project Includes:
